Skip to content
Current/ Help Center

Task dependencies: types, lag, and the dependency map

2 min read · Updated Jul 21, 2026

Dependencies are what let Current compute a real schedule instead of just a list of dates — one task's timing drives another's. Add a dependency from either the task drawer or the Dependencies map.

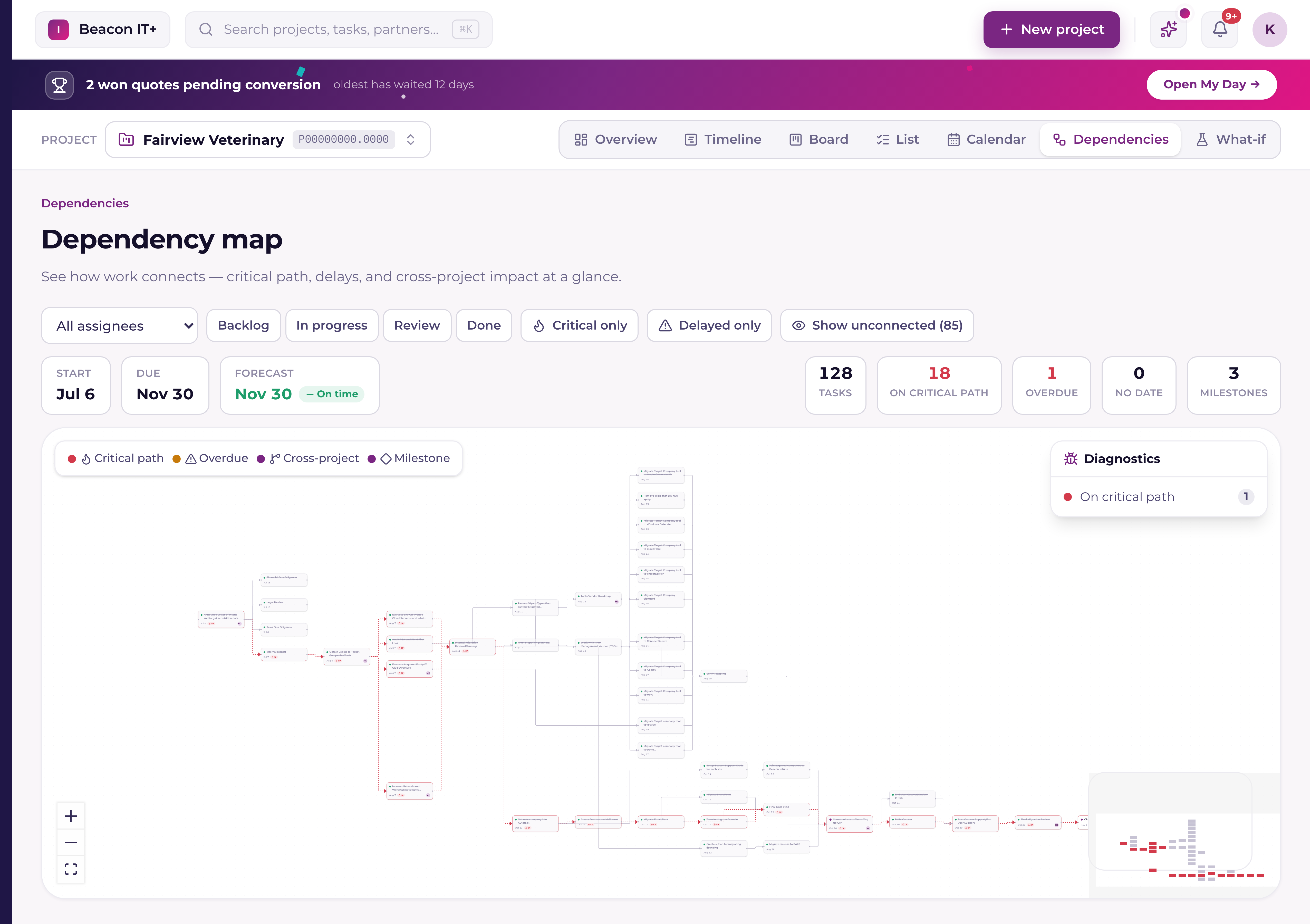

The dependency map — every task is a node, every arrow a predecessor → successor link, and the zero-slack critical path is drawn in red. The stat cards up top count tasks, critical-path tasks, and milestones.

The four dependency types

Current supports all four standard project-scheduling dependency types:

TypePlain-language meaning
Finish → StartThis task starts once the other one finishes — the most common link.
Start → StartBoth tasks start at the same time.
Finish → FinishThis task can't finish until the other one finishes.
Start → FinishThis task finishes when the other one starts — rarely used.

Adding lag

Every dependency can carry a lag — a number of working days added (or subtracted, for lead time) between the two tasks. A lag of +2 days means the successor waits two extra working days after the dependency is satisfied; a negative lag lets the successor start early.

  1. 1
    Open the task and go to Dependencies
    From the task drawer, or click a task on the Dependencies map.
  2. 2
    Pick the other task
    Choose whether it's a predecessor (this task waits on it) or a successor (it waits on this task).
  3. 3
    Choose the type
    Finish → Start is the default and covers most cases.
  4. 4
    Set lag if needed
    Leave at 0 for back-to-back, or add days for a required gap (e.g. waiting for hardware to arrive).

The Dependencies map

The Dependencies view lays out every task and its links as a visual graph, auto-arranged left to right. Tasks on the critical path are highlighted in red with a thicker, animated edge; links between tasks in different projects are shown as dashed purple edges. A diagnostics panel flags tasks that are on the critical path, overdue, forecast to slip, an at-risk milestone, missing dependencies entirely, carrying invalid dates, or missing a work estimate.

Working with dependencies in the task drawer

Open a task and its Dependencies section lists what it's waiting on and, under "Waiting on this", the tasks waiting on it. Every row is a real, clickable link that always shows the actual task name — never a generic "task" placeholder, even when the other task was archived or removed.

  • Click any dependency row to jump straight to that task; a Back control returns you to where you started.
  • A task that no longer exists reads "Deleted task", and an archived task carries an (archived) tag — so a broken or hidden link is obvious instead of mysterious.
  • A dependency on a task in another project shows that project's name next to it, so a cross-project link is never ambiguous.
  • Remove buttons are always visible on every row — including the "Waiting on this" rows — and the add-dependency picker shows a clear loading state instead of disappearing while it loads.
Note
Who can change a task's dependencies
You can add or remove what a task waits on if you can manage projects (Project Manager and up) OR you are the assignee of the task that's doing the waiting. That means an engineer can now manage their own task's predecessors without a PM stepping in — but changing what waits on someone else's task still needs project-manage rights.

How circular dependencies are blocked

Current checks every new dependency before it's added: it traces forward from the task you're about to make dependent, and if that trace ever loops back to the task you started from, the link would create a cycle — an impossible schedule where two tasks each wait on the other. Current blocks the add and tells you it would create a circular dependency.

Note
Cross-project dependencies
A task in one project can depend on a task in another — useful for shared milestones like a company-wide cutover. When you're working in the dependency map or a What-if scenario, a linked task that lives in a different project is treated as a fixed point: Current schedules around it but never quietly moves it, so you can't reshape work you don't own without meaning to. Just double-check that both projects' owners are aware; a change on one side can still move dates on the other.
Was this helpful?
